China Shenhua,a subsidiary of China Energy Investment Corporation

China Shenhua,a subsidiary of China Energy Investment Corporation

Summary

RailwayCare has long-termly provided grinding solutions for China Energy Investment Corporation, covering the Shenmu-Shuozhou Line and Huanghua Line, with a cumulative grinding distance of 20,000 kilometers.

Project Overview

RailwayCare provided comprehensive rail grinding solutions for the railway transportation network of Shenhua Group, a subsidiary of CHN Energy Investment Group. This two-year project covered multiple heavy-haul railway lines under Shenhua Group, aiming to improve track quality, extend equipment lifespan, and reduce maintenance costs.

As China's largest coal producer, Shenhua Group's railway network carries critical energy transportation tasks. Track quality directly impacts transportation efficiency and safety. RailwayCare's systematic grinding solution helped Shenhua Group address long-standing issues such as corrugation wear and side wear.

Total Grinding Mileage

20,000

Kilometers

Project Results

Through this project, RailwayCare helped Shenhua Group achieve:

⚪  42% reduction in track surface roughness
⚪  30% reduction in wheel wear rate
⚪  28% improvement in train running stability
⚪  5-10 year extension in track service life

Project Process

This project adopted a systematic, phased implementation approach to ensure each stage met the highest standards. Below is the complete project process:

Phase 1: Preliminary Preparation

Project Initiation

March 2022: RailwayCare's first meeting with Shenhua Group's technical team to define project objectives and requirements.
Feasibility Analysis
Comprehensive assessment of Shenhua Group's existing track conditions, analyzing grinding technology applicability and expected outcomes.
✓ Preliminary identification of suitable grinding machine models and grinding wheel specifications

Phase 2: Proof of Concept

Initial POC Testing
Selected a 5km test section on Shenshuo Railway for initial grinding tests, collecting baseline data.
✓ Testing equipment performance and collecting baseline data
Test Problem Discussion & Feedback
Held specialized meetings with Shenhua's technical team to analyze issues discovered during testing and optimize grinding parameters and equipment configuration.
✓ Adjusting grinding wheel formula, optimizing grinding machine parameters
Secondary POC Testing
Conducted a second round of testing on the same section with adjusted grinding parameters based on feedback.
✓ Verifying equipment optimization results
POC Summary
Completed test data analysis report, demonstrating the grinding solution effectively addressed Shenhua's specific track issues.
POC Presentation
Presented test results to Shenhua Group management, obtaining technical approval and authorization for further progress.

Phase 3: Project Implementation

Project Establishment
September 2022: Shenhua Group formally included "Full Network Rail Grinding Project" in its annual key projects.
Higher Authority Review
Project proposal submitted to CHN Energy Group headquarters for joint review by technical and budget committees.
Approval Granted
November 2022: CHN Energy Group officially approved the project.
Procurement Scope Confirmation
Defined project coverage of railway lines, grinding standards, equipment requirements, and implementation timeline.
✓ Determining quantity and specifications of required grinding machines and grinding wheels

Phase 4: Procurement & Execution

Tender Initiation
January 2023: Shenhua Group issued a public tender announcement for rail grinding services.
Bid Submission
RailwayCare submitted technical proposal and commercial bid, winning the contract after three rounds of bidding.
✓ Proposal included technical advantages of grinding machines and RC-LGT-Molaton260 grinding wheels
Grinding Delivery

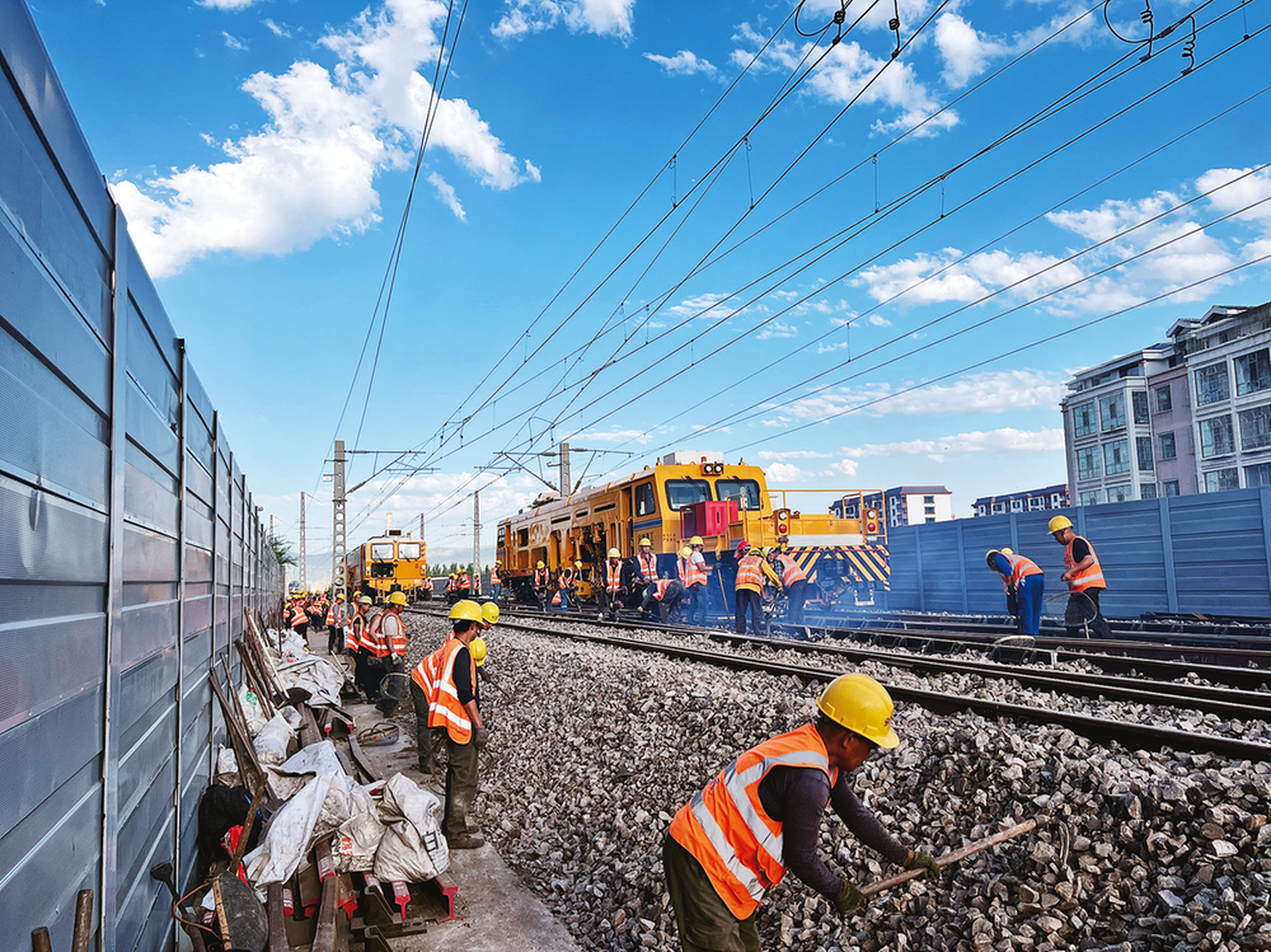

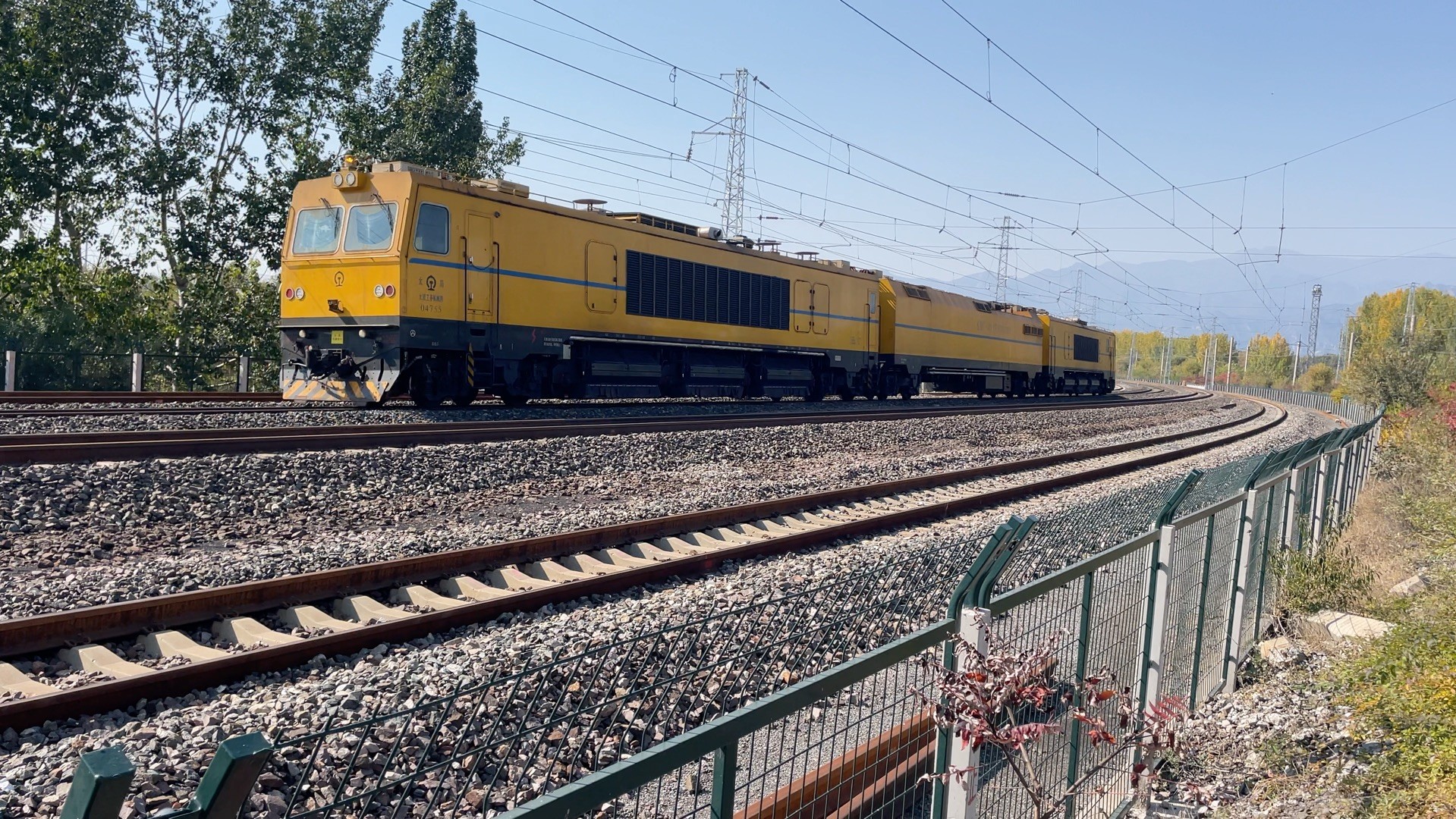

March 2023 - December 2023: Conducted grinding on 20,000km of Shenhua Group railways using 8 RG-8000 grinding machines and matching HS-88 grinding wheels, in three phases.
✓ Peak period deployment of some grinding machines to ensure project progress
Final Acceptance
December 2023: Project passed technical acceptance by Shenhua Group, with all indicators exceeding targets.
Phase 5: Continuous Service
2024 Maintenance Services
Provided annual regular inspections, equipment calibration, technical training, and emergency response services to ensure continuous and stable grinding results.
✓ Regular replacement of grinding wheels, maintenance of grinding machines
2025 Optimization Services
Based on over a year of operational data, provided grinding parameter optimization, equipment upgrade recommendations, and preventive maintenance plans.
✓ Provided upgraded version of  RC-LGT-Molaton260  grinding wheels with 15% performance improvement
Long-term Technical Support
Established long-term cooperation relationship, providing continuous technical consultation, equipment maintenance, and upgrade services.
